Berkeley Square August 2025 Update

Berkeley Square continues to make excellent progress on Ordsall Lane, currently nine weeks ahead of programme. With power now live on site and major…

市场营销
• 9 月 9, 2025

Berkeley Square continues to make excellent progress on Ordsall Lane, currently nine weeks ahead of programme. With power now live on site and major milestones across the façade, apartments, and roof terraces completed, The Heaton Group is moving steadily towards early completion. The project remains on track to meet the planned completion date of October 2025, subject to final certification and power on formalities.

发生了什么

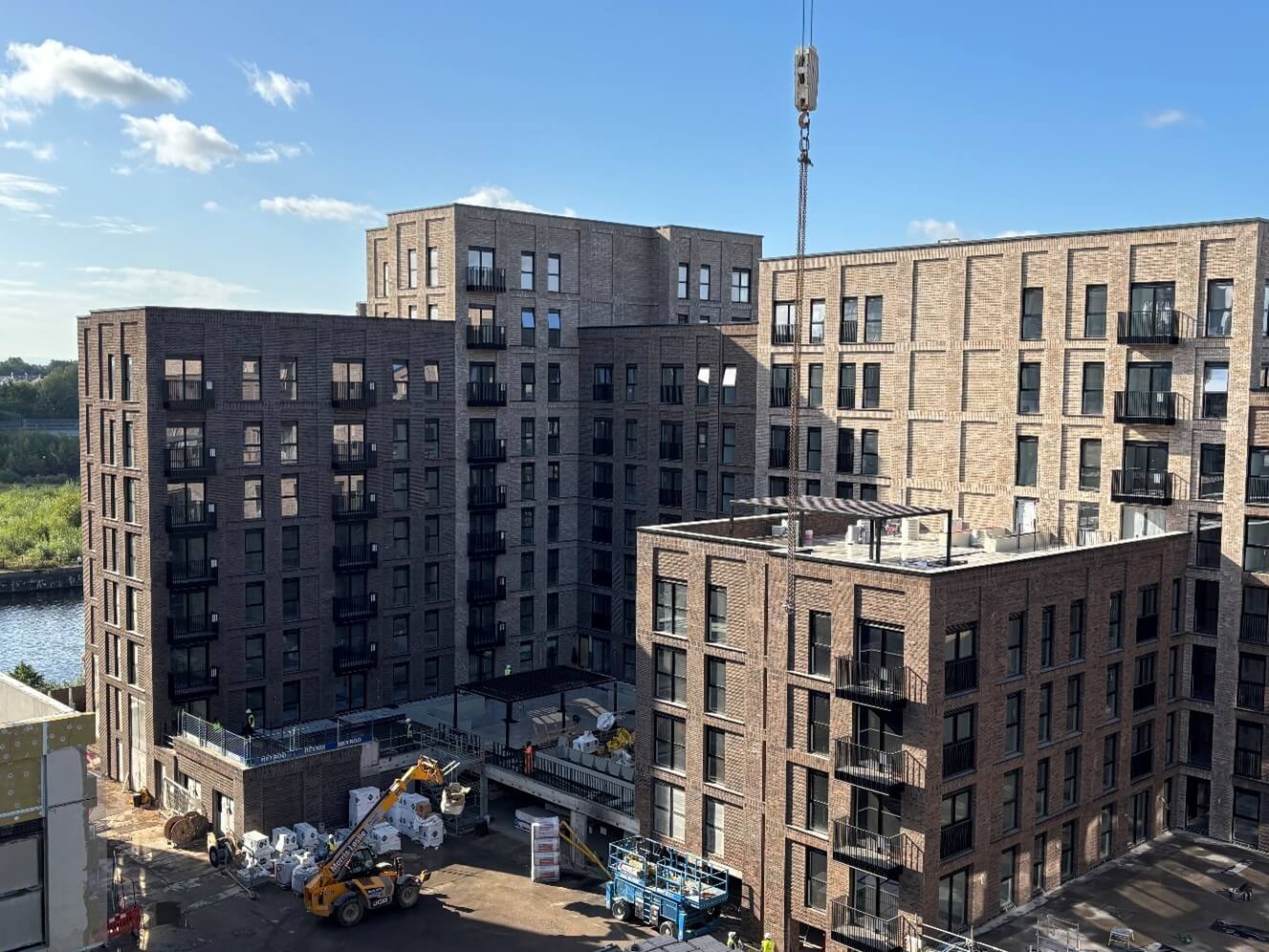

  • Façade and External Works: The low-level brick slip system has been completed, with all mast climbers removed. Hard and soft landscaping has progressed well, with 22/26 mast climbers stripped. Acoustic fencing has also been installed.
  • Apartments and Internal Works: All apartments are complete, aside from snagging and carpet installation on level 8. M&E commissioning has been completed to all apartments, with second fix works ongoing at lower ground floor. Corridor carpets and final decoration continue to progress, while staircase and lift lobby plastering is now complete. Escape stair walls have been boarded.
  • Balconies and Roof Terraces: All balconies have been installed. Roof terrace insulation, paving, and balustrading have progressed on levels 4 and 7.
  • Lifts and Services: Lift installation and final commissioning are complete. PV system installation is finished, and all walls, soffits, and sprinkler systems have been completed following hoist removals.

近期活动

• Complete façade snagging and final finishes.
• Final M&E and lift commissioning.
• Install ventilation grills to car park walls.
• External hard landscaping works.
• Roof terrace insulation, paving, and balustrading.
• Decoration of stairs and corridors.
• Lower ground floor M&E second fix.
• Installation of wayfinding signage.

设计与质量

• Planning conditions tracker remains active; all conditions have been submitted except Condition 5 (remediation pending topsoil completion), pending feedback.
• NMA 2 submission is under consideration by SCC Planning, pending feedback.
• Air tests have been completed across all apartments, achieving an average result of 2.75. Acoustic testing is complete, with the final report issued, confirming all standards met.

展望未来

With the project now firmly ahead of schedule, Berkeley Square is moving into its final stages with confidence. As roof terraces, landscaping, and internal finishes are completed, and wayfinding signage is installed, the building continues to take shape visibly and impressively.

敬请期待更多更新。

请与我们联系!

更多信息 曼彻斯特伯克利广场请查看我们的专门页面:

曼彻斯特伯克利广场

欢迎直接与我们联系:

01942 931300 // sales@heatongroup.co.uk // 预约电话 // 预约看房

最新职位:
Tranquillity August 2025 Update
9 月 9, 2025
Tranquillity July 2025 Update
8 月 6, 2025
伯克利广场 2025 年 7 月更新
7 月 30, 2025
宁静的曼彻斯特 2025 年 5 月更新
5 月 31, 2025
联系方式

投资者入职

开始您的下一次房产投资之旅。 让我们开始吧。

自我介绍:
关于您的投资

如图
